Kitchen Renovation Timeline: A Week-by-Week Guide for GTA Homeowners

Introduction

"How long will this take?" is one of the first questions homeowners ask when starting a kitchen renovation. It's also one of the most variable — because the honest answer depends on several factors specific to your project.

That said, most kitchen renovations in the GTA fall within a predictable window, and understanding why each phase takes the time it does will help you plan realistically and avoid the most common scheduling surprises.

Here's a practical, week-by-week breakdown of what a typical kitchen renovation involves — and what affects the timeline at each stage.


Typical Kitchen Renovation Duration

For a standard kitchen renovation in the Greater Toronto Area — including new cabinetry, countertops, tile backsplash, lighting, and plumbing fixtures — expect a total timeline of 3 to 6 weeks from the start of construction.

This estimate assumes:

  • Cabinets have been ordered and delivered before demolition begins

  • Countertop templates are taken after cabinet installation

  • No major structural changes (removing load-bearing walls adds 1–2 weeks)

  • Permits, if required, are secured before work starts

The 3 to 6 week range accounts for variation in project scope, material lead times, and the condition of what's discovered behind existing walls.


Before Construction Starts: The Planning Phase

Most of the timeline surprises in kitchen renovations don't happen during construction — they happen (or are avoided) in the weeks before it begins.

Design and Material Selection (2–6 Weeks Before Construction)

Cabinet lead times are the single biggest scheduling variable in kitchen renovations. Semi-custom and custom cabinets typically require 3 to 6 weeks from order confirmation to delivery. Stock cabinets are available faster but offer limited sizing options.

Countertop materials also have lead times. Quartz and engineered stone typically require 2 to 3 weeks from template to installation. Natural stone like quartzite or marble may take longer depending on slab availability.

The practical implication: don't schedule construction to begin until your cabinets are confirmed for delivery. Many renovation delays stem from starting demolition before materials are secured.

Permits (If Required)

Permits are required when kitchen renovations involve changes to electrical panels, new plumbing rough-ins, or structural work such as removing a wall. Cosmetic renovations — replacing cabinets, countertops, and fixtures in their existing locations — generally do not require permits.

In Richmond Hill and the broader York Region, permit processing typically takes 2 to 4 weeks once an application is submitted. Your contractor should clarify permit requirements during the initial assessment and factor this into the project schedule.


Week-by-Week Construction Timeline

Week 1: Demolition and Rough-In Work

Construction begins with controlled demolition: existing cabinets, countertops, flooring (if being replaced), and tile are removed. The space is cleared to the studs and subfloor.

Once the existing materials are out, rough-in work begins. This includes:

  • Electrical: adding or relocating outlets, installing dedicated circuits for appliances, rough-in for new lighting

  • Plumbing: relocating or adding supply and drain lines if the sink or dishwasher position is changing

  • HVAC: adjusting ductwork if layout changes require it

Rough-in work must be inspected and approved before walls are closed — a step that adds 1 to 3 business days depending on municipal scheduling.

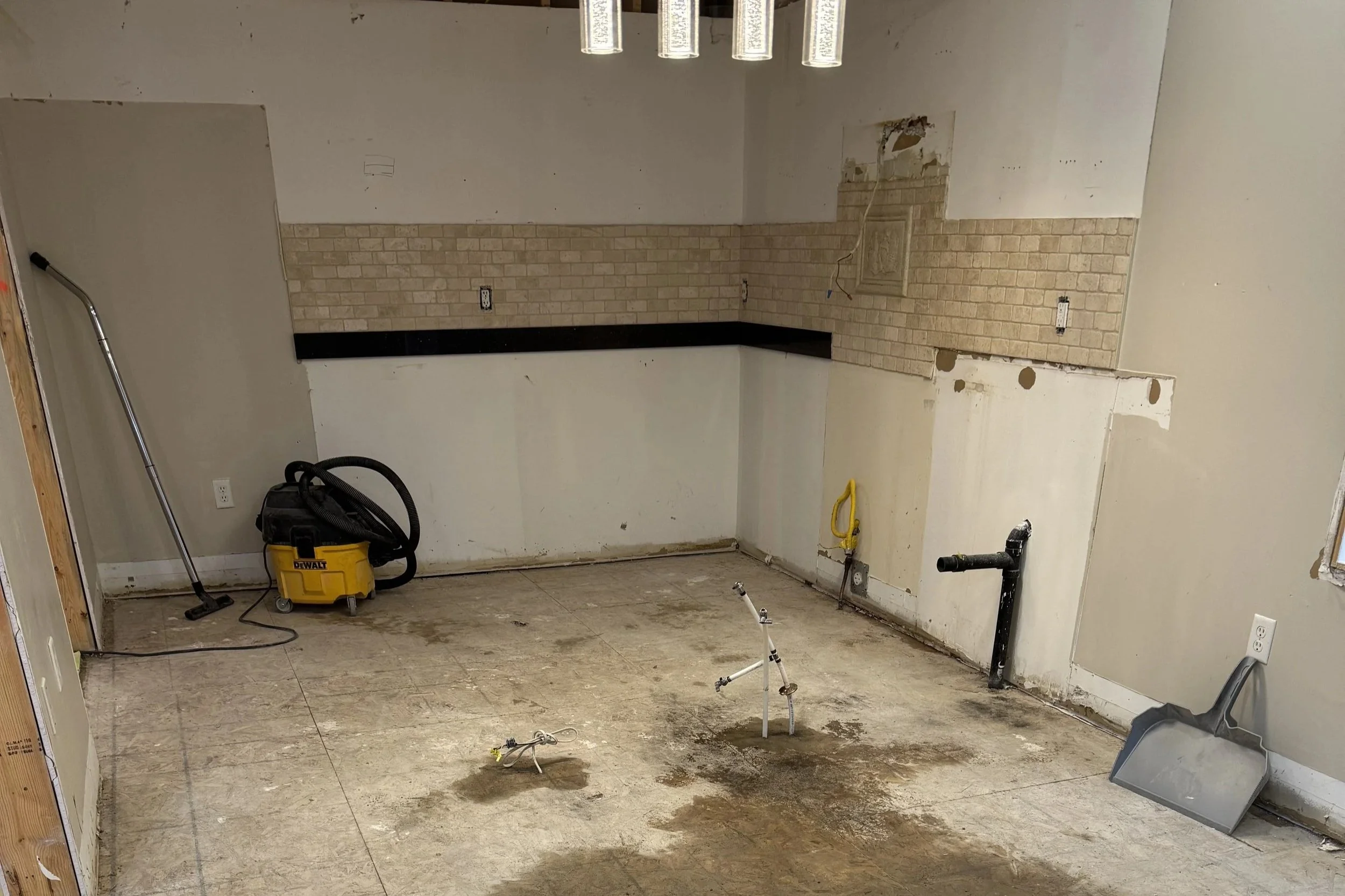

Demolition progress in Markham Home

Week 2: Drywall, Priming, and Cabinet Delivery

After inspections pass, drywall is patched or replaced, taped, and sanded. This stage also includes priming the walls before cabinet installation.

Cabinet delivery ideally aligns with the end of Week 1 or beginning of Week 2, so they are on-site and ready to install immediately after the space is prepared. Good project scheduling minimizes the gap between delivery and installation.

Week 3: Cabinet Installation

Cabinet installation is a precision trade. Upper cabinets are hung first, then base cabinets are installed and levelled. For a standard-sized kitchen, cabinet installation typically takes 2 to 4 days.

Once cabinets are installed, the countertop template is taken. This is a critical measurement step — the template captures the exact dimensions of the countertop after cabinets are set in their final position. Fabrication then begins.

Week 4: Countertop Fabrication and Plumbing Fixtures

This week often involves waiting for countertop fabrication, which typically takes 7 to 14 business days from template. While fabrication is underway, other work can proceed:

  • Tile backsplash installation (if countertops are not required first for layout reference)

  • Under-cabinet lighting rough-in and fixture preparation

  • Appliance delivery and rough positioning

  • Hardware installation on cabinets

Week 5: Countertop Installation and Finishing Trades

Countertop installation is a 1-day process. Once slabs are set, the sink is cut and plumbing connections are completed. Appliances are connected and tested.

Finishing trades during this week typically include:

  • Electrical: installing light fixtures, switch plates, and outlet covers

  • Backsplash grouting and sealing (if tile was installed earlier)

  • Touch-up painting

  • Flooring transition strips and base mouldings

Week 6: Detailing, Inspection, and Handover

The final week is focused on details that determine the quality of the finished result: cabinet alignment and hinge adjustments, silicone bead application at backsplash and countertop joints, hardware calibration, and thorough cleaning.

A final walkthrough with the project manager ensures every element meets the standard before handover. Any punch list items are completed during this stage.

What Extends a Kitchen Renovation Timeline

Several factors consistently push kitchen renovations beyond the standard 3 to 6 week window:

Structural Changes

Removing a load-bearing wall adds significant complexity — engineering drawings, structural beam installation, temporary support, and inspection. Budget an additional 1 to 2 weeks for projects involving structural changes.

Unexpected Conditions

Older GTA homes regularly reveal plumbing that needs upgrading, outdated electrical panels, or water damage behind existing finishes. When discovered during demolition, these issues must be resolved before the project can continue. Setting aside a 10–15% contingency in both budget and schedule is a standard professional practice.

Material Delays

Supply chain delays, incorrect orders, or damaged materials on delivery can push back specific phases. The best protection is ordering materials early and confirming lead times before construction starts.

Living at Home During a Kitchen Renovation

Most homeowners remain in their home during a kitchen renovation. With proper planning, this is manageable.

Practical tips:

  • Set up a temporary kitchen space: a countertop, microwave, kettle, and a mini fridge in a different room

  • Stock up on groceries that don't require cooking in the first 1–2 weeks

  • Discuss a daily work schedule with your project manager so you know when the team will be on-site

  • Expect dust, especially during demolition and drywall — cover furniture in adjacent rooms

The Nuance Approach to Scheduling

At Nuance Design Build, every kitchen project is assigned a dedicated project manager who coordinates all trades and material deliveries. Our clients receive a written schedule before construction begins, and we update them at each major milestone.

The goal is simple: no surprises. The timeline we present at the start reflects the actual sequence of work — not an optimistic estimate that falls apart in Week 2.

If you're planning a kitchen renovation in Richmond Hill, Markham, Vaughan, or the surrounding GTA, we're happy to discuss your timeline and scope in a free initial consultation.
